|
|
Status
|
Construction scheme
(current) |
|
Contractor
|
Charles
Brand Group Ltd
|
|
Scheme
|
To
realign a bad bend on the A45
Ballynakilly Road at Creenagh Bridge,
Coalisland.
|
|
Total
Length
|
160 metres |
|
Dates
|
1 Jun 2025 - Contract
awarded
Sep 2025 - Work began
30 April 2026 - Road
completed opened to the public
(ahead of scheduled completion of
Summer 2026 as of Aug 2025)
|
|
Cost
|
£1.9m (changed from
£1.6m as of Aug 2025) |
|
See
Also
|
General
area map
|
Click
here to jump straight down to updates
for this scheme.
The A45 is a strange U-shaped A-class road that
serves Coalisland and Dungannon. It leaves the
M1 motorway at junction 14, heads through
Coalisland, then through Dungannon and re-joins
the A4 dual-carriageway at Granville. The most
confined spot is Creenagh Bridge (known locally
as Hogg's Bridge) on the southern edge of
Coalisland, where the road turns at 90°
immediately after crossing the Torrent River.
The reasons are historic. Creenagh Bridge was
once on a straighter section of 18th century
road that is still there today – made up of
Loughview Road (to the north) and Creenagh

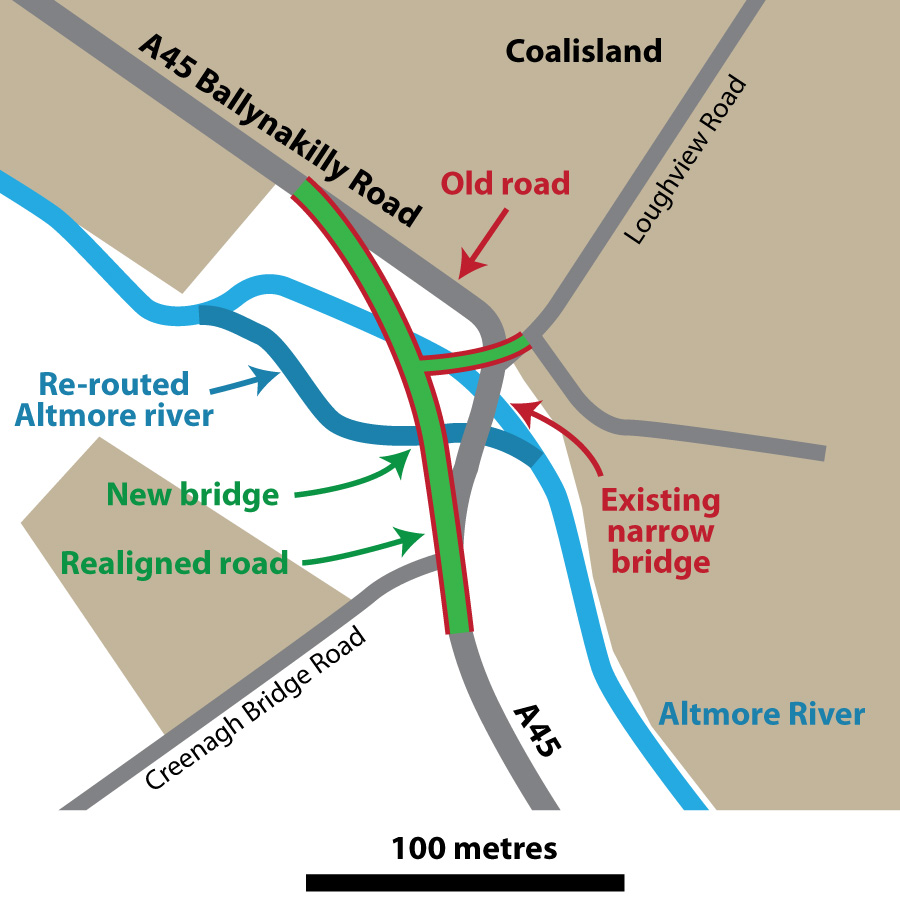

Bridge Road (to the south) – see map below. In
the 19th century, the Ballynakilly Road was
built to offer gentler gradients and it was
awkwardly glued into each side of the bridge,
creating the current setup. This was fine in the
days of stagecoaches, but it is problematic for
HGVs today.

The solution is to demolish the existing
concrete beam bridge and replace it with a new
concrete culvert bridge with 160 metres of new
road following a gentler curve. This work also
requires the existing river to be diverted to
the south over a short length. Once the river
has been diverted, a short length of new road
will connect Loughview Road to the new
alignment.
Updates
24 Apr 2026: The speculation I reported
two weeks ago was correct – the road will
open fully at 4pm on 30 April 2026. This
is significantly ahead of schedule – at project
commencement it was planned to complete in the
summer of 2026. The press release also gives the
final price as £1.9m, slightly higher from the
£1.6m that was quoted in August 2025. DFI
Minister Liz Kimmins said "The Bridge
replacement and significant road realignment
will improve safety for pedestrians and road
users on the A45 Ballynakilly Road between
Coalisland and the M1 Motorway. It will
also assist with heavy goods vehicle movement
and improve commercial connectivity in this
area. This substantial investment also
includes the construction of an Active Travel
footway for 270metres over the scheme linking
to the Ballynakilly Road, which will deliver
significant benefits for residents and road
users who travel through this area. These
schemes demonstrate my commitment to improving
our road and active travel networks which are
vital for connecting our businesses and
communities." Congratulations are
due to Charles Brand Group Ltd for an excellent
piece of work. The drone photos below were
released by DFI and show the scheme at the start
left) and almost completed (right). The show not
only the re road, but the realigned Torrent
river.

10 Apr 2026: A post
on Facebook by Dan Kerr from Wednesday
shows some interesting ground-level views of the
scheme. The post also suggests that scheme
completion is now due around the end of April,
due to some adverse weather. That is still well
ahead of the date of "summer 2026" that we were
expecting at project commencement.
4 Mar 2026: Children from a local
primary school visited
the works a couple of weeks ago. Civil
engineering projects are a great thing to bring
children to see, partly because it teaches them
how the built environment comes to exist, and
partly because it may inspire some to seek a
career in civils. It's hard to tell from the
images, but it does look as if the new bridge might
be getting a stone parapet, which would match
the old bridge.
27 Jan 2026: Just a very quick update to
share this
wonderful drone movie of the scheme taken
by Sean Mcaliskey on Christmas Eve. It shows the
new bridge completed, the old one gone (though
with some utilities from the old bridge still in
place over the gap!) and the bed for the new
road largely completed. The main task now will
be to construct the new road over all these new
foundations and reopen the road. The official
schedule is to have it completed by the summer,
but with such good progress it could happen
sooner than that.
24 Nov 2025: A quick update to share some
more photos from the site taken within the
past few days. As you can see the earth approach
embankments to the new bridge appear to now be
under construction.
10 Nov 2025: Sean McAliskey posted
a video of the works on Facebook on 2
November. It shows not only the new box culvert
finished, but also the Torrent River already
diverted beneath it. You can see the current
state of the works in the video, including a
closeup of the green textiles that are used to
strengthen the earth river banks to give time
for nature to reclaim it. Presumably work will
now focus on the area that the river used to
occupy, to prepare the foundations for the
diverted road. the old bridge will also need
removed at some point, though it doesn't look as
if the contractor is in a rush to do that.
22 Oct 2025: Work got underway
about six weeks ago and so far has progressed
rapidly. The road has been closed completely for
the duration of the works, since the river
diversion requires the removal of the original
road at an early stage. The Facebook post here
was put up two weeks ago and shows the new box
culvert bridge partially completed and
excavation for the new route of the river
underway. Thanks to all who wrote to me about
this scheme.
|
